How long does a bathroom remodel take in Miami?

How long does a bathroom remodel take? In Miami, a tub-to-shower conversion is usually about a week of work; a full gut of a hall bath runs two to six weeks on site and a primary bath five to eight, after design, orders and the permit.

Typical time by type of job

Most of the calendar is set by the scope: the more pipes and walls you move and the more tile you set, the more stages the job goes through. These are the ranges we plan around, counted in working days on site.

JobWork on siteWhat comes before
Tub-to-shower conversion3 to 7 days; custom tile or curbless can pass a weekMaterial order, permit if the drain moves
Guest or hall bathroom, full gut2 to 6 weeksDesign, orders, permit
Primary bathroom, full gut5 to 8 weeksDesign, custom vanity and glass orders, permit

Once you add design time and plan review to the orders, a full remodel commonly lands somewhere between two and four months from the first visit to the last inspection. A smaller swap like the one on our tub to shower conversion page sits at the short end because the room keeps its layout.

Before demo: design, material orders and the permit

The paperwork and the orders come first, and together they often take longer than tearing the room out. A custom vanity or special tile can have a lead time of weeks, so we order before demo instead of waiting with an open wall.

When the job moves a drain, a wall or a circuit, it needs a permit. Plan review rarely approves a set on the first pass; comments come back, we answer them and resubmit. The guide to Miami-Dade and Broward bathroom permits covers who issues it and what each city asks for.

Stage by stage on site

Once the permit card is on the door, the work follows a fixed order, and each step waits for the one before it.

  1. Protection and demo take half a day to two days. We cover floors and the path to the door, then strip the room to the studs and slab.
  2. Plumbing and electrical rough-in run 2 to 10 days depending on how much moves. A licensed plumber and a licensed electrician do that work, and nothing gets covered until the inspector has seen and approved it.

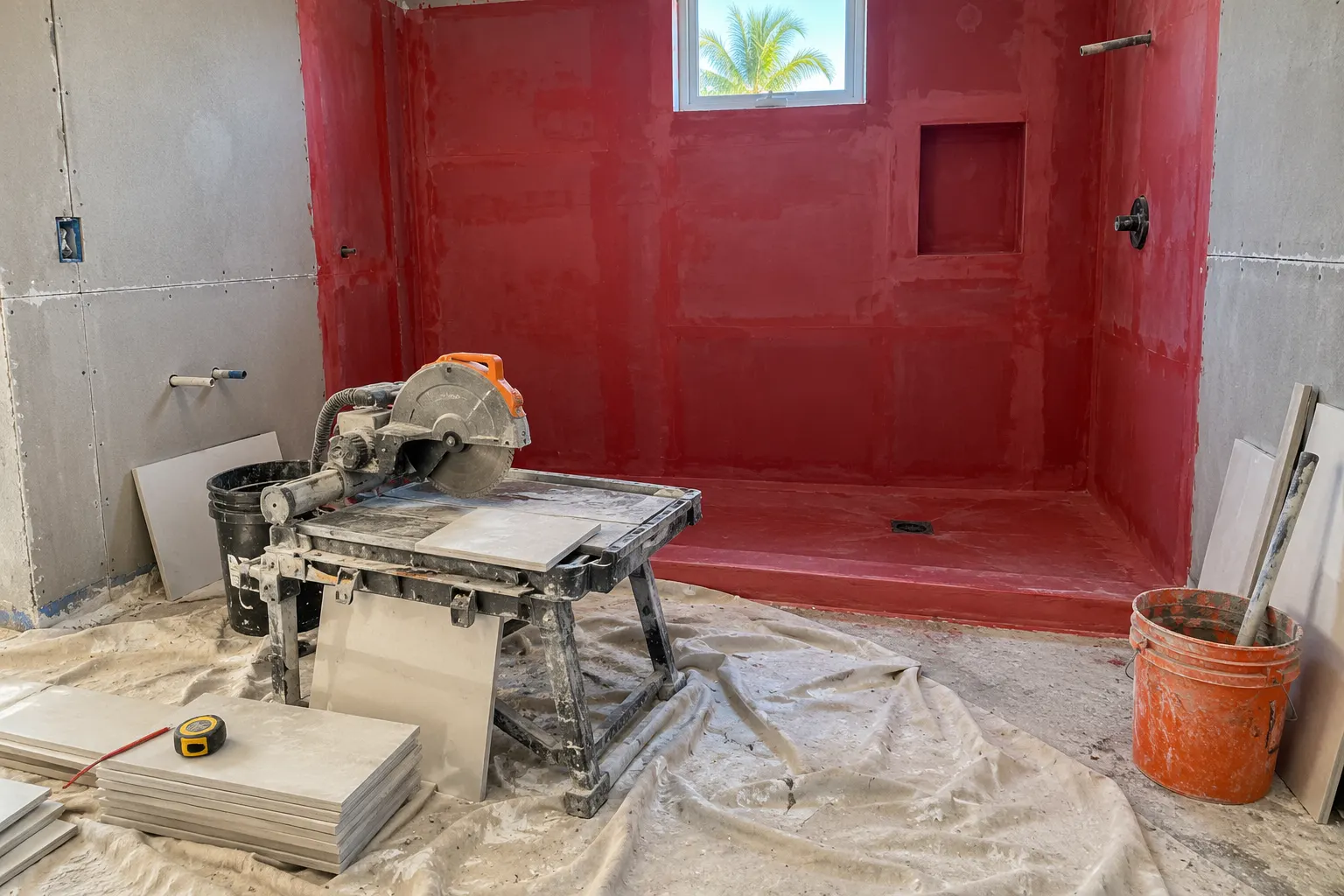

  3. Backer board and waterproofing come next. Cement board goes up, then the membrane over the pan and curb and up the walls; seams are usually left about a day to set. The full method is in our pan and membrane walkthrough.
  4. The flood test happens before any tile. We plug the drain and fill the pan; the code minimum is 2 in of water held for 15 minutes, while membrane makers recommend a 24 hour test, so we prefer to leave it overnight.
  5. Tile is usually the longest stretch, 3 to 7 days. Large-format porcelain goes slower because each piece is back-troweled for full mortar coverage in the wet area.
  6. Grout and setting materials then cure. Depending on the product, that is 3 to 7 days before the shower can get wet, and Miami humidity can stretch it.
  7. Finish work closes the job. The vanity and fixtures go in with the trim, and the glass is measured once the tile is set, so it is the last piece in, followed by the final inspections for each trade.
Text us photosWith a few photos of your bathroom, its rough size and your city, we give you a first price before we visit.

What makes a bathroom remodel run longer

Three things push the calendar out more than anything else: what we find behind the walls, condo rules and special tile.

Surprises behind the wall

Homes built before 1975 often still have cast iron drains, and demo is when we see their real condition. When a hidden drain or supply line has failed and has to be replaced, Miami-Dade treats it as new work, which means a permit and an inspection of its own. Rotted subfloor gets priced and approved by you before we repair it, which adds a few days.

Condo buildings

In a tower, the association has to approve the scope before anything starts, and the building decides the hours we can work and when we get the service elevator. Any coring through a post-tensioned slab waits for the association, an engineer and a concrete scan. Our condo bathroom remodel page explains that process.

Special tile and late changes

Stone, handmade tile or very large slabs add cutting and setting time. Moving a fixture after rough-in is the costliest delay, since the new pipe needs another inspection before the wall closes.

How we keep the schedule

You get a written schedule with every stage before we start, updated whenever an inspection date or a hidden problem moves it. The whole sequence, from the first visit to cleanup, is laid out on how we run a remodel.

Frequently asked questions

Can we live at home while the bathroom is being remodeled?

Yes, most families stay if there is a second bathroom. In the City of Miami, construction noise is not allowed between 6 PM and 8 AM on weekdays or at all on Sundays and holidays, so the work fits normal daytime hours.

When can I take the first shower in the new bathroom?

Count on several days after the grout goes in, up to a week. The exact wait depends on the grout and setting products, and humid weather slows the cure. We tell you the date once the tile is finished.

Do inspections slow the job down?

The visit itself is short, but getting a slot can take a few days, so we book it as soon as the pipes and wiring are in.

Why is the glass installed last?

The glass is cut to the finished tile, not the bare wall, so we can only measure it after tile is set. Fabrication takes time after that, which is why the shower may be usable a few days before the door goes on.

Reviewed

Ready to remodel your bathroom?

Text us a few photos of your bathroom, its rough size and your city. We send you a first price and set a day to come measure.
